Forecasting

52 viewsUpdated 18/09/20261 min read

The forecast answers the only cost question anybody outside the commercial team asks: what is this job going to finish at?

This topic includes:

Forecast a budget line

Open the forecast and set, line by line, how that line is expected to finish.

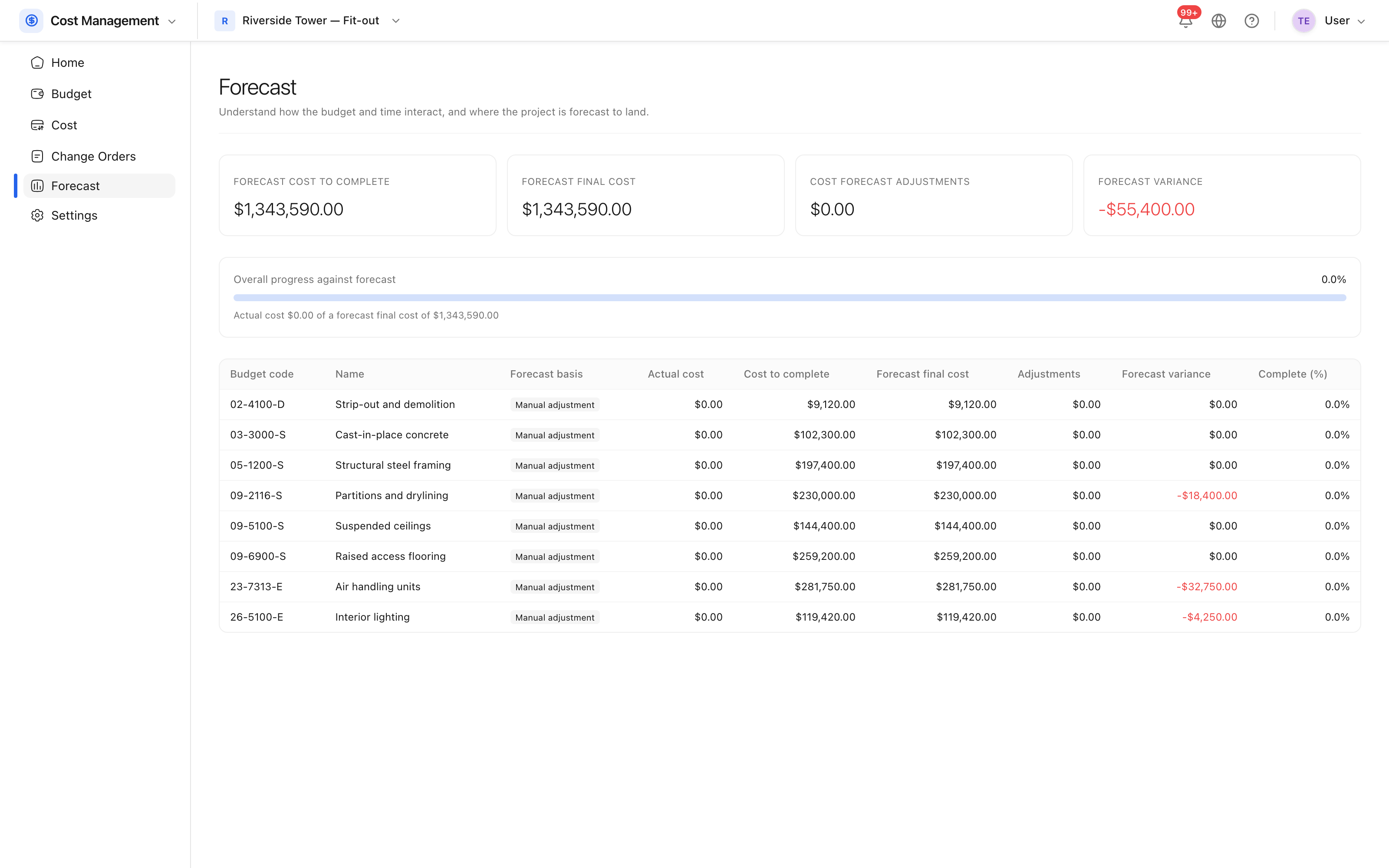

The forecast Each budget line with its forecast basis and its projected final cost.

Lines with no forecast are carried at their revised budget, which is a reasonable default and a bad assumption to leave in place on a line you know is overspending.

The three bases

BasisEnterSuits
Manual adjustmentCost to complete, or the final cost directlyLines you have a view on
Output completeUnits forecast, units done, or percent completeMeasured work — square metres of partition
Date rangeThe window the resource is spread overTime-related cost — preliminaries, plant hire

Output complete is the honest one where the work is measurable: it derives the final cost from the rate the work is actually going at, rather than from somebody's optimism.

What happens to the variance

Where the forecast differs from the revised budget, the difference can either be saved as a variance — reported, and left to be explained — or turned into an adjustment, which generates a potential change order for the difference.

Save it as a variance while you are still working out whose it is. Turn it into a PCO once you know, so that it enters the change process rather than sitting in a spreadsheet.
